So, your VA construction loan has closed. Now what?

Many veterans assume construction starts the day after closing. In practice, the builder first pulls permits and readies the site, and then the build moves through draws, inspections, and possibly change orders before the loan converts to your permanent mortgage.

This guide covers the VA construction loan process and timeline from closing day to move-in: what happens at each stage, how long it usually takes, and how to keep the build on schedule.

What Happens After a VA Construction Loan Closes?

Once the loan closes, the project goes into construction: draws, inspections, builder coordination, and any change orders.

Once the home is complete and fully approved for occupancy, the loan will be converted to a permanent mortgage known as VA Construction to permanent loan. Your loan includes a 12-month construction period from closing. How quickly you move in within that period depends on how construction progresses and the pace of local permits and inspections.

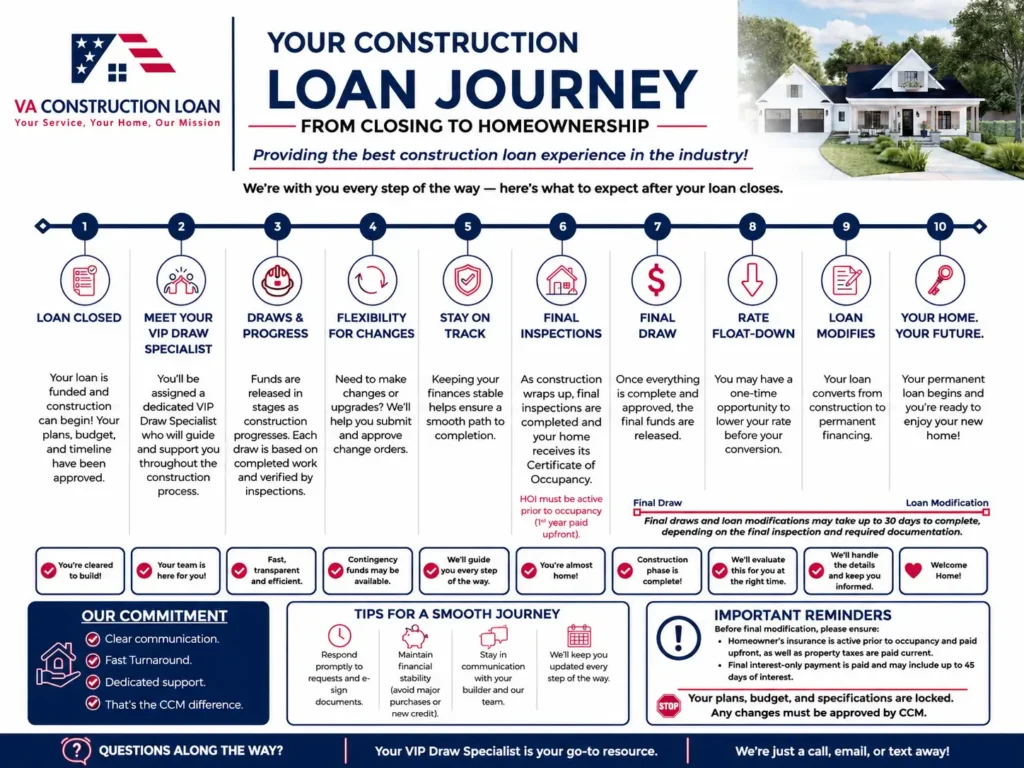

The VA Construction Loan Process Timeline: Step-by-step

Every loan is different, though, and most VA construction loans will follow these general steps after closing:

Construction StageTypical Timeline
Loan ClosingDay 1
Draw Specialist IntroductionDays 1–7
Site Preparation & FoundationWeeks 1–4
Framing & Structural WorkMonths 2–4
Mechanical SystemsMonths 3–6
Interior FinishesMonths 5–9
Final InspectionsMonths 6–11
Certificate of OccupancyNear Completion
Final Draw ReleaseFinal Week
Loan Modification (conversion)After final inspection and final draw
Permanent Mortgage BeginsImmediately After Conversion

Stage 1 — Loan Closes: Your VA Construction Loan Is Officially Active

Closing starts the construction phase. Construction funds become available and are released according to the approved draw schedule. Once the builder has the permit and the lot is ready, construction can begin.

Your loan package will already contain:

  • The approved building plans

  • The budget for the project

  • The draw schedule

  • The contract with the builder

  • Contingency money

  • The VA funding fee, unless you are exempt

Don't expect equipment on the lot the day after closing. The builder often spends the first couple of weeks getting permits, lining up subcontractors, and readying the site.

Construction work generally should not begin before the construction loan closes. Starting work too early can create financing eligibility issues and may delay the loan process.

Stage 2 — Construction Administration Begins

After closing, construction begins once permits are issued and the builder is ready to start. Throughout construction, the lender's construction administration team coordinates inspections, draw approvals, title updates, and fund disbursements. Builders typically request funds as construction milestones are completed, and borrower authorization is often required before funds are released.

Stage 3 — The VA Construction Loan Draw Schedule: How and When Funds Are Released?

The builder does not receive the loan in a lump sum. Construction money is released in phases based on progress, and an inspection comes before each draw.

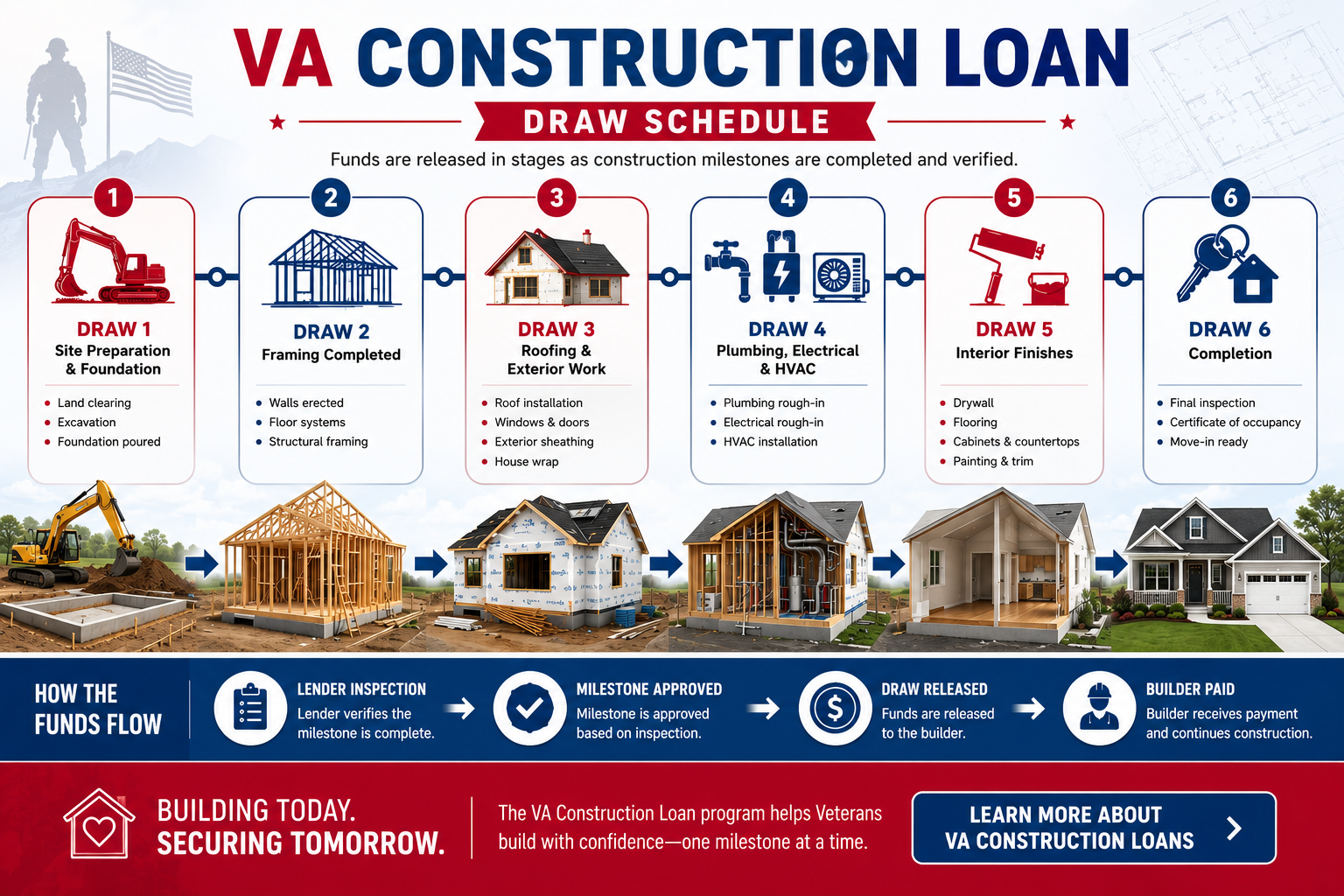

Example Draw Schedule

While draw schedules vary by lender and project, construction funds are generally released in phases as work is completed and verified through inspections.

What Most Veterans Don't Know?

Paying only for inspected work protects both you and the lender.

Stage 4 — Change Orders During VA Construction: What's Allowed and What Needs Approval

A change order is a formal request to alter the construction plans, specifications, materials, or scope of work after construction has begun.

Common construction changes may include:

  • Upgrading countertops
  • Changing flooring selections
  • Adding a patio or outdoor living space
  • Relocating interior walls
  • Modifying fixtures or finishes

Change orders and project upgrades can impact construction timelines, inspections, and approval processes. Depending on the project and loan structure, additional costs may need to be paid from contingency reserves or directly by the borrower. Significant changes may also require updated documentation, revised project schedules, or additional inspections before work can proceed.

Before closing, the builder must be reviewed and approved by the lender for the project. Many lenders require builders to meet specific qualification standards related to licensing, insurance, experience, and financial stability before construction can move forward.

Check the builder requirements before proceeding.

Stage 5 — Staying Financially Stable During the Construction Phase

Keep your finances steady through the build.

You make no payments during the build: the interest reserve and construction management fee are built into the loan amount and paid by the builder.

To help keep your project on track, avoid:

  • Taking out new vehicle loans
  • Accumulating large credit card balances
  • Missing loan or credit payments
  • Making major employment changes
  • Taking on significant new debt

For example, purchasing a new vehicle during construction could increase your overall debt obligations and affect your financial profile. Significant financial changes during the construction period may create challenges if additional reviews or documentation are required before the home is completed.

Whenever possible, consider postponing major financial commitments until after you have moved into your new home.

Stage 6 — Final Inspections and the Certificate of Occupancy

When construction is finished, final inspections begin.

Inspectors confirm:

  • Building conforms to approved plans.

  • Building code is complied with.

  • Safety codes are followed.

  • Mechanical systems are in working order.

  • Required permits are obtained.

Any identified defects must be corrected before proceeding.

What is a Certificate of Occupancy?

A Certificate of Occupancy (CO) is a document issued by the local government confirming that a building is habitable.

You cannot typically move into a house without a Certificate of Occupancy.

For most borrowers, the CO is the last big milestone before being a homeowner.

Stage 7 — The Final Draw: Closing Out the Construction Phase of Your VA Loan

Once all final inspections pass and the Certificate of Occupancy has been issued, the lender is ready to proceed with the final draw.

The final draw accomplishes several tasks:

  • Pays for all final construction bills.

  • Settles up all final construction billings to the builder.

  • Closes out construction accounting.

  • Proves project completion.

Construction is now complete, and the loan is moving into permanent financing.

Stage 8 — The Rate Float-Down: Your One-Time Opportunity to Lower Your VA Mortgage Rate

The build takes up to 12 months, and mortgage rates can move during that time.

Some VA one-time close construction loan lenders offer a float-down feature that may allow borrowers to reduce their interest rate before permanent financing begins if market conditions improve. Availability and requirements vary by lender.

Not all programs are eligible for this feature. Read the terms of your loan carefully.

Stage 9 — VA Loan Modification: How Your Construction Loan Converts to a Permanent Mortgage

The key benefit of using a one-time close construction loan (VA one-time close) is the ability to skip a second closing. Your lender will begin the modification and transition your construction loan into a mortgage.

This usually involves:

  • Review of final inspection.

  • Confirmation of a certificate of occupancy.

  • Reconciliation of the final draw.

  • Finalization of documentation.

  • Confirmation of your permanent mortgage terms and payment structure.

Because the loan already closed once, there is no second closing and much less paperwork.

The transition from construction financing to permanent mortgage financing typically begins after construction is complete and all required inspections, occupancy approvals, and final project documentation have been received and approved.

Stage 10 — Your Permanent VA Mortgage Begins: What Changes and What to Expect

The building phase is officially complete at the time of the loan modification. Once you complete this task, your temporary construction financing is converted to your permanent VA loan.

At this point:

  • Construction financing ceases

  • Regular mortgage payments are started

  • Escrow account is active (if any)

  • Normal mortgage servicing is established

  • The home is complete and ready to live in.

This marks the end of the VA Construction Loan Process & Timeline.

What Can Delay a VA Construction Loan After Closing?

Delays happen, even in well-managed projects. You'll be more likely to prevent future problems if you're aware of the usual issues:

  • Builder Documentation Delays: Missing or incomplete builder paperwork can slow project approvals and loan processing.
  • Permit Delays: Local permitting and regulatory reviews may take longer than expected, depending on the jurisdiction.
  • HOA or Architectural Review Approvals: Communities with homeowners associations or architectural review boards may require additional approvals before construction can proceed.
  • Appraisal Revisions: Changes to plans, specifications, or project costs may require updated valuations or additional reviews.
  • Material Shortages: Delays involving windows, HVAC equipment, specialty products, custom materials, or other building components can affect timelines.
  • Weather Delays: Severe weather conditions may interrupt site preparation, inspections, deliveries, or construction activities.
  • Change Orders: Modifications to the original construction plans can impact budgets, schedules, inspections, and project coordination.

While many delays are beyond a borrower's control, maintaining communication with the builder, lender, and other project participants can help identify issues early and keep the project moving forward.

Tips to Keep Your Project on Schedule

  • Don't alter plans once construction starts.

  • Keep open lines of communication with the builder.

  • Respond quickly to lender requests.

  • Keep a close watch on draw activity.

  • Keep money management steady throughout construction.

  • Organize your project records.

VA Construction Loans — Building Homes for Those Who Served.

Your VA loan benefit lets you build a home designed around your family. Shirley Mueller, Sr. VP of Veteran Lending at CrossCountry Mortgage, has specialized in VA home loans for over 20 years, and her team works with veterans and their builders from closing through conversion to the permanent loan.

Contact Shirley for personalized help that will guide you safely to permanent financing for your new home.

The online application takes about 10 minutes and uses a soft credit pull only.

Frequently Asked Questions

  1. How long does it take to close a VA mortgage loan?

The time it takes to close a VA mortgage loan depends on various factors, including the property appraisal, underwriting process, title work, lender efficiency, and how quickly required documents are provided. For a VA construction loan, plan on about 2–3 months from application to closing. You can often reduce delays through several ways to speed up closing a VA loan, such as getting pre-approved, submitting paperwork promptly, and responding quickly to lender requests.

  1. How Many Draws Are Allowed In A VA Construction Loan Draw Schedule?

The number of draws varies based on the builder, project scope, lender requirements, and approved draw schedule. Construction funds are generally released as milestones are completed and verified.

  1. Who Orders And Pays For The Inspections Required Before Each Draw?

The lender orders an inspection before each draw. The inspection confirms the work the builder reports as complete has actually been done, which protects you and the lender. Who pays the inspection fees depends on the lender and your builder contract; your Loan Estimate will show any inspection fee charged to you.

  1. Can The Construction Loan Convert To Permanent Financing Early If The Build Finishes Ahead Of Schedule?

Early construction completion can speed up permanent VA financing. The house has to pass all inspections, get a Certificate of Occupancy, and the lender needs to clear the house. Once all requirements are met, the lender can begin modifying the loan into a permanent financing product.

  1. What Happens To The Unused Contingency Funds At The End Of Construction?

Unused contingency funds are applied to your loan principal when the loan converts to permanent financing.

  1. Is There Any Waiting Period Between The Final Draw And When The Loan Modification Is Processed?

There is usually little to no wait time after the last disbursement. Once the final inspection, certificate of occupancy, and completion documents are in hand, the lender can process the modification. This typically takes a few business days to a few weeks.

  1. Can I Move Into The Home Before The VA Construction Loan Officially Converts Into A Permanent Mortgage?

As a general rule, you can move in after the Certificate of Occupancy is issued and the lender approves occupancy. Requirements vary: some lenders don't allow occupancy until the final draw is released, and others require additional paperwork.
